Timber framed woodshop

On Christmas day 2014, I went for a hike in the San Jose hills with my sister and our farm dog, Chapa. The hills, which turn golden in the summer, were a lush green from the recent rains. I love the escape from city life that this farmland offers. I also love to learn with my hands and hope to open the door for others for whom classroom-style learning is not enough, too much, or just not the way they work.  I decided that I would build a timber framed woodshop here.

hills of San Jose

In late February 2015, I made some sketches of the would-be woodshop/house. After touring the timber framed barns of New England the previous summer, I drafted up a 18 x 24 dutch-barn style structure with a mezzanine and loft. The bottom floor I intend to use as a woodshop, the mezzanine for storage, and the loft as a studio where I (or others) could live or stay for a while.

woodShopFullFrame woodShopSiding

At the end of May, I moved my sailboat with me across the country and started work. The foundation are 2 ft x 2 ft concrete footers, 4-5 ft deep. I did the digging by hand with the help of a local carpenter, who consulted me on foundation work, and a foam roller (which kept my back alive).

digging

forms

filledfooters2

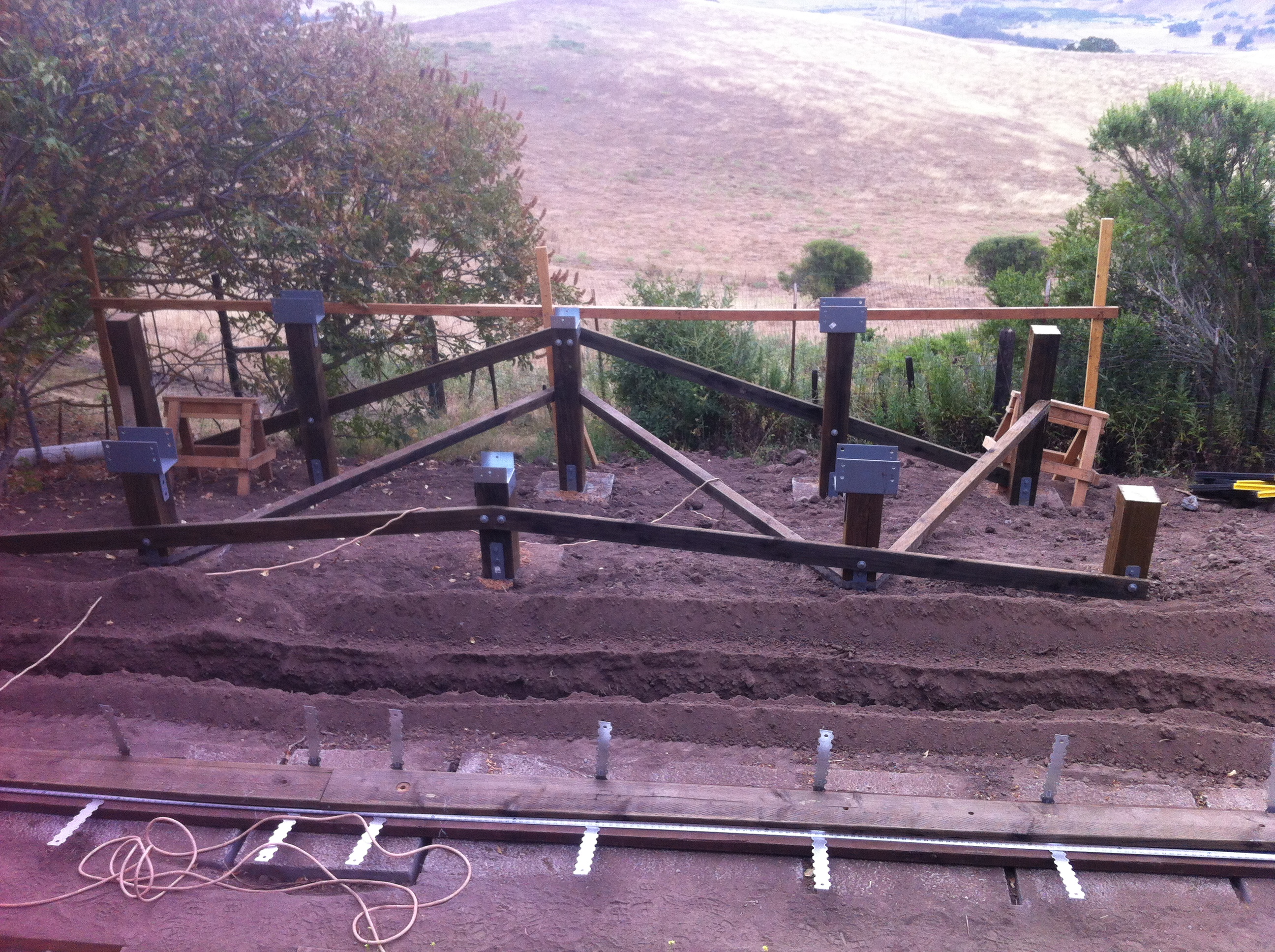

foundation

Unfortunately, there was no time to get a road put in to the site, so instead I built a small railroad to transport building material and timbers.

railroad

With the help of my family and a gas-powered chain trencher, we dug and laid wire/pipe for electrical and water to the site in June.

electrical trenchThe timber delivery came the second week of July, grade 2 or better Douglas Fir from Berry’s Sawmill in Santa Rosa.
stagingGood friends came from across the country to help timber frame the floor system and first “bent” (a cross section of a timber frame, i.e., wall). No nails or screws are used in timber frame construction, rather the joints (cut with a framing chisel and mallet) hold the timbers together.

framing

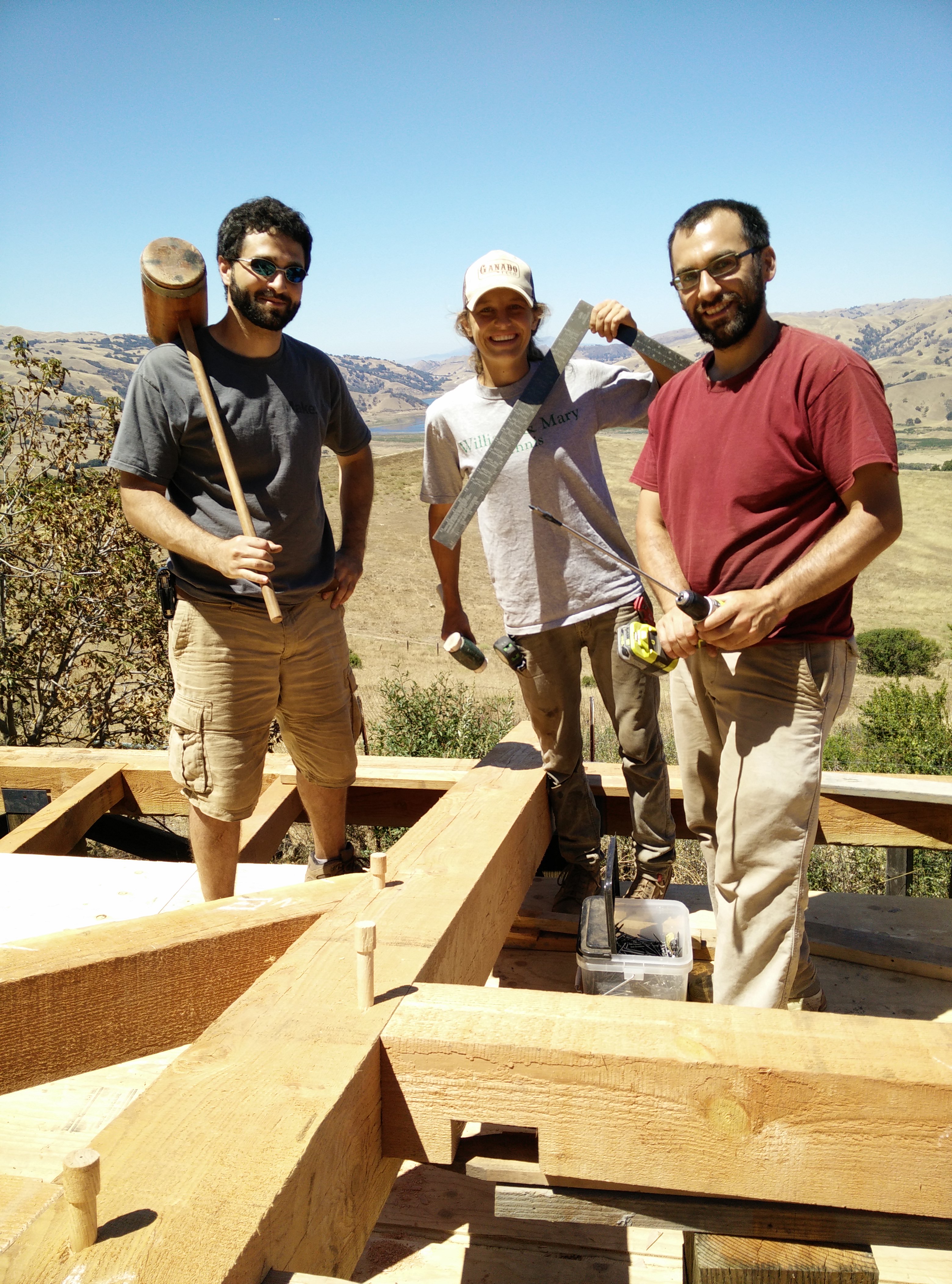

framingFriends

Floor system: sills and joists

floorSystem

In addition to friends coming and going, the animals keep me company:

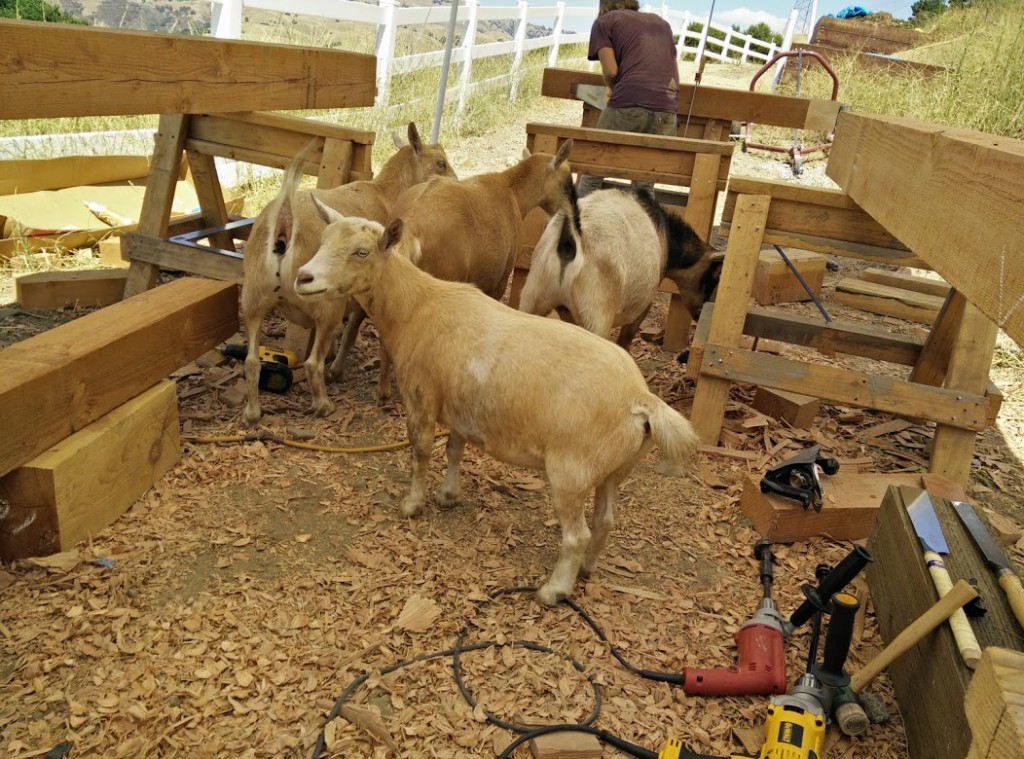

goatsAndFraming

fixingAndChapa

The first bent went up late July. Each bent weighs roughly a ton and was raised with the help of a gas powered winch (attached to a gin pole) and 5-6 very patient friends and family members:

halfOfH

bent1

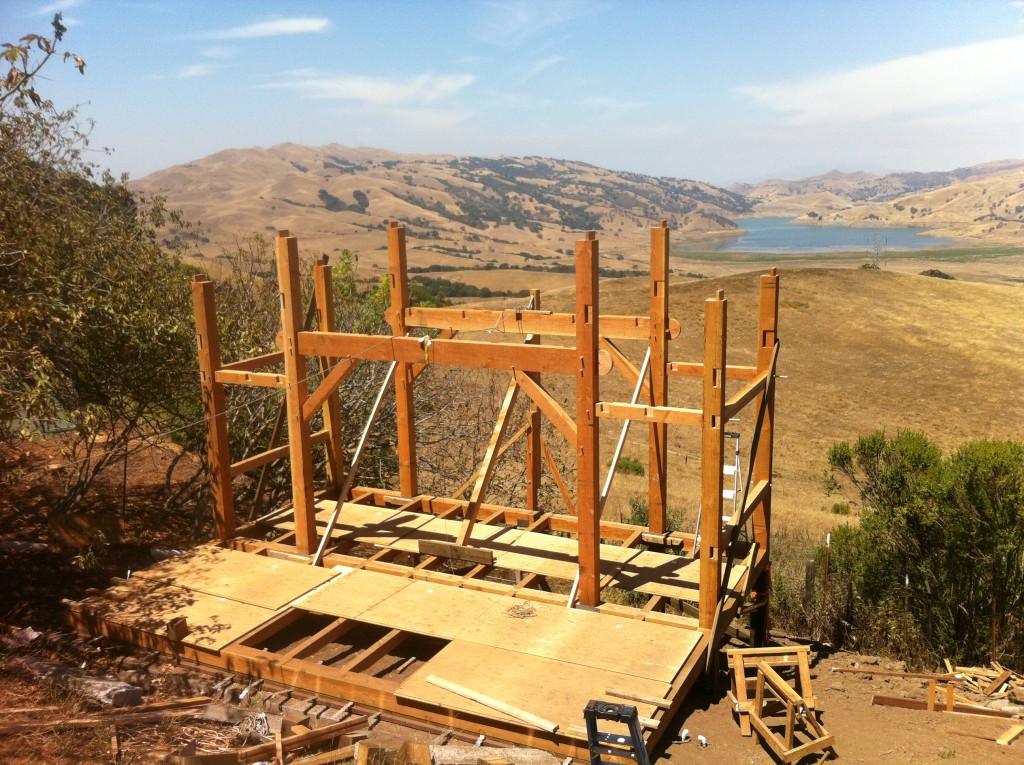

The second bent was raised the first week of August:

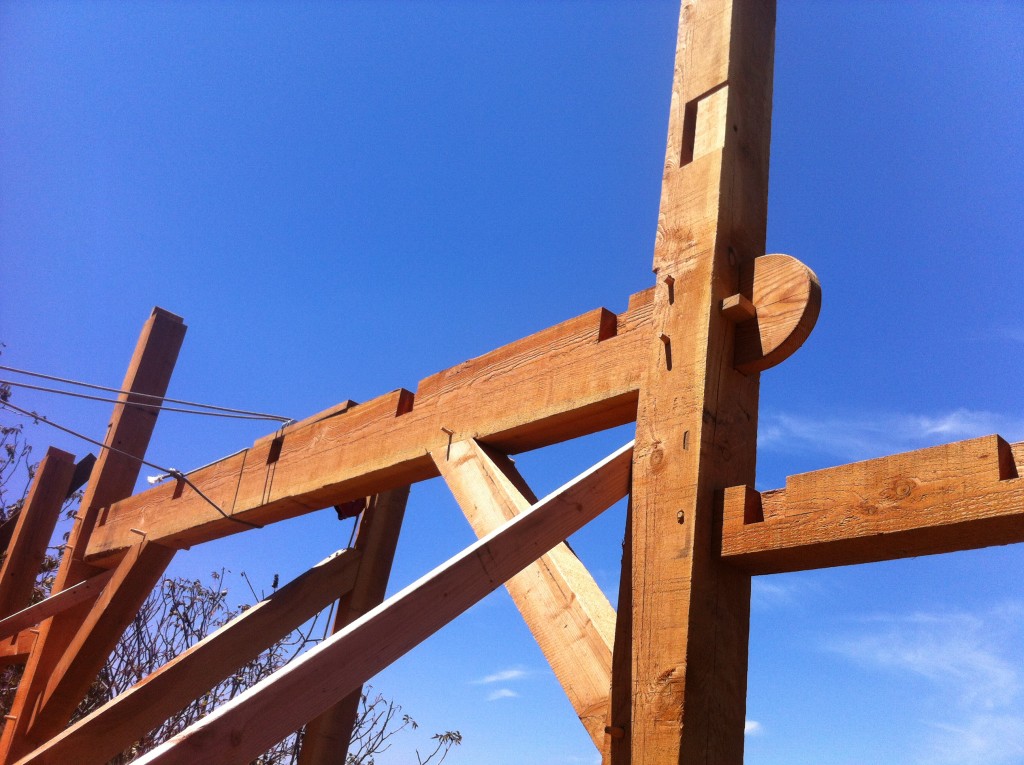

secondBent anchorBeam

The third (and last) bent was raised the third week of August:

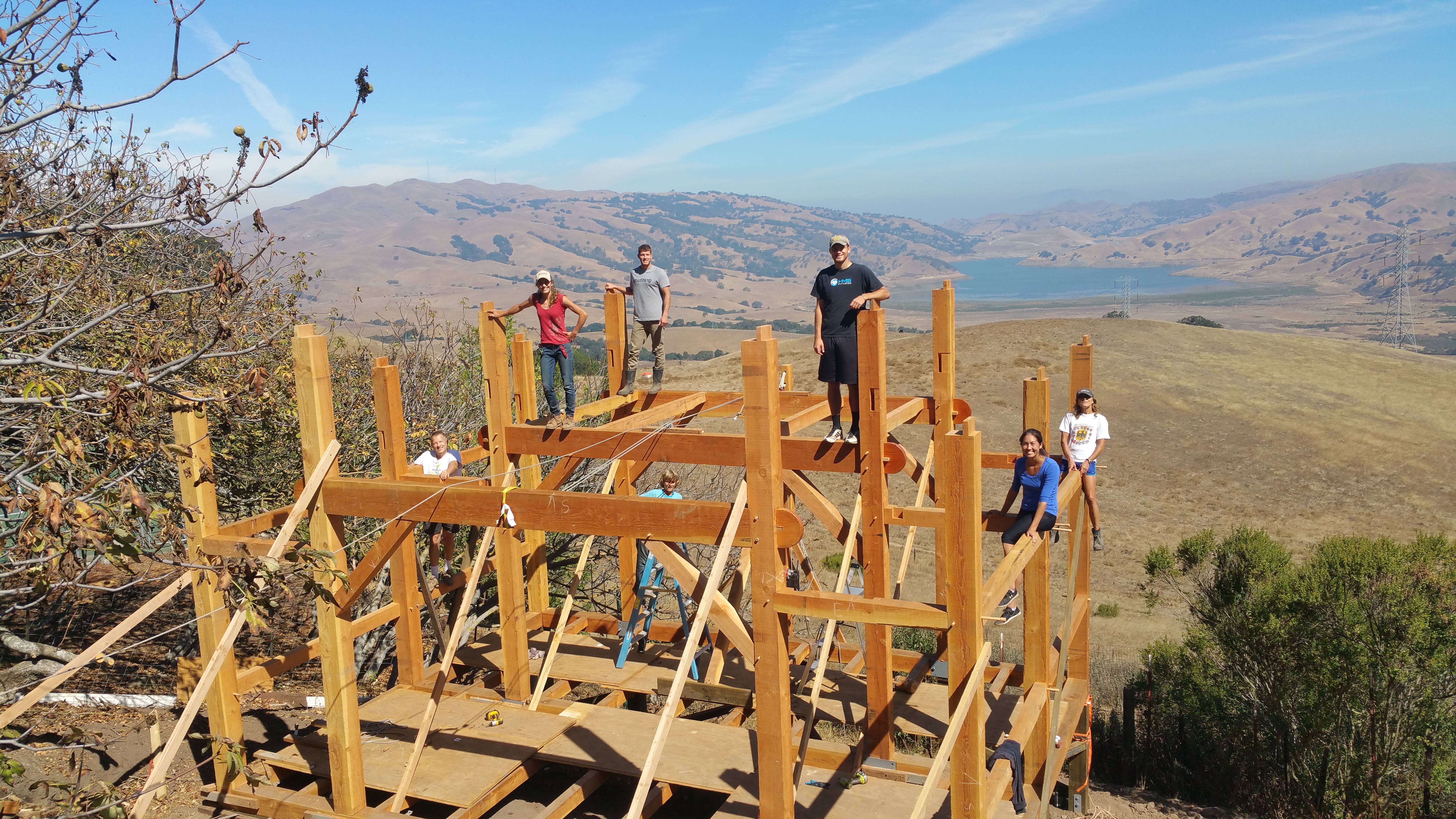

bent3_me bent3_family

To raise the top plates, which lock all the bents together, I first decked out the mezzanine and loft:

loftJoists secondFloorJoists floorJoists

The top plates were raised in late August, mid-Septmeber:

topPlate loft2 topPlate2

The full frame (minus the rafters):

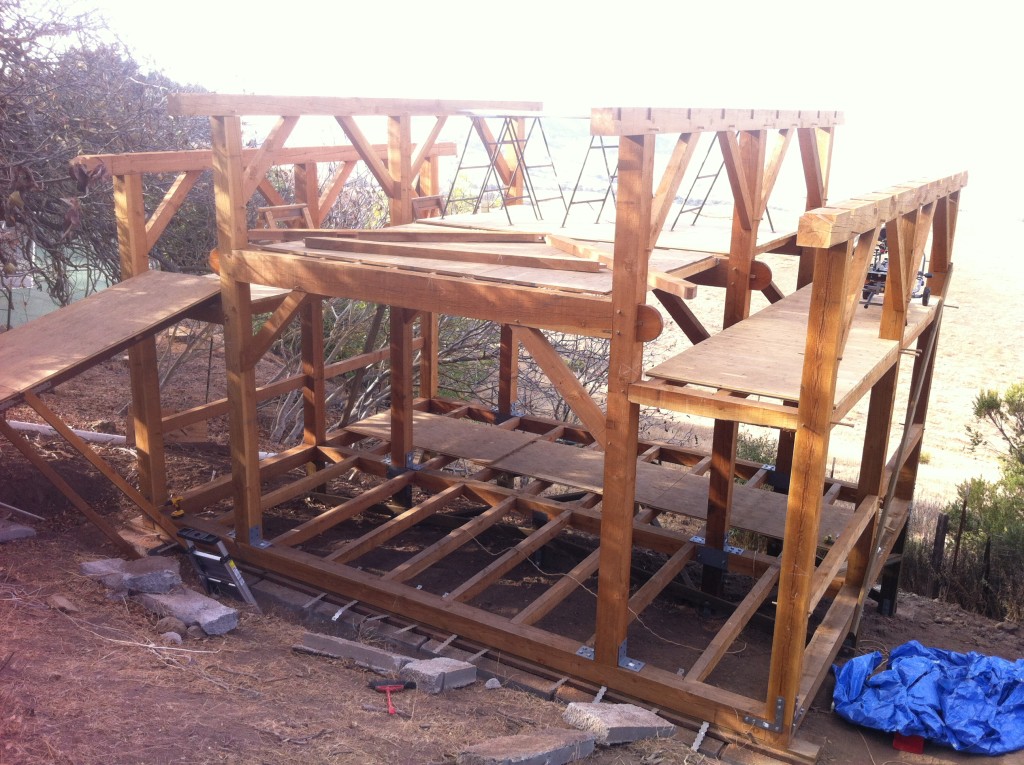

frameMinusRafters

The first few rafters were assembled in late August:

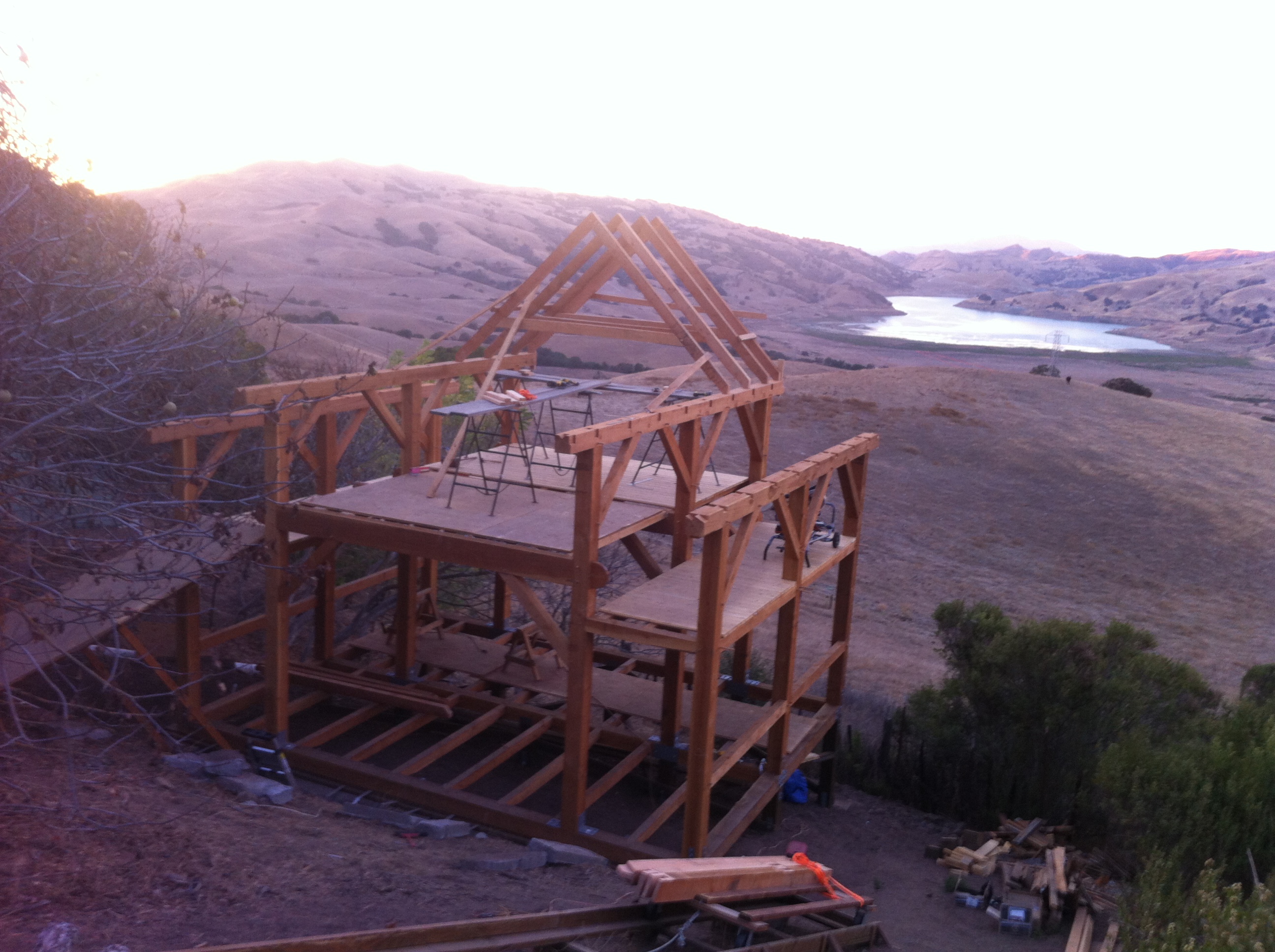

firstRafters

The rest of the rafters went up the first week of September.

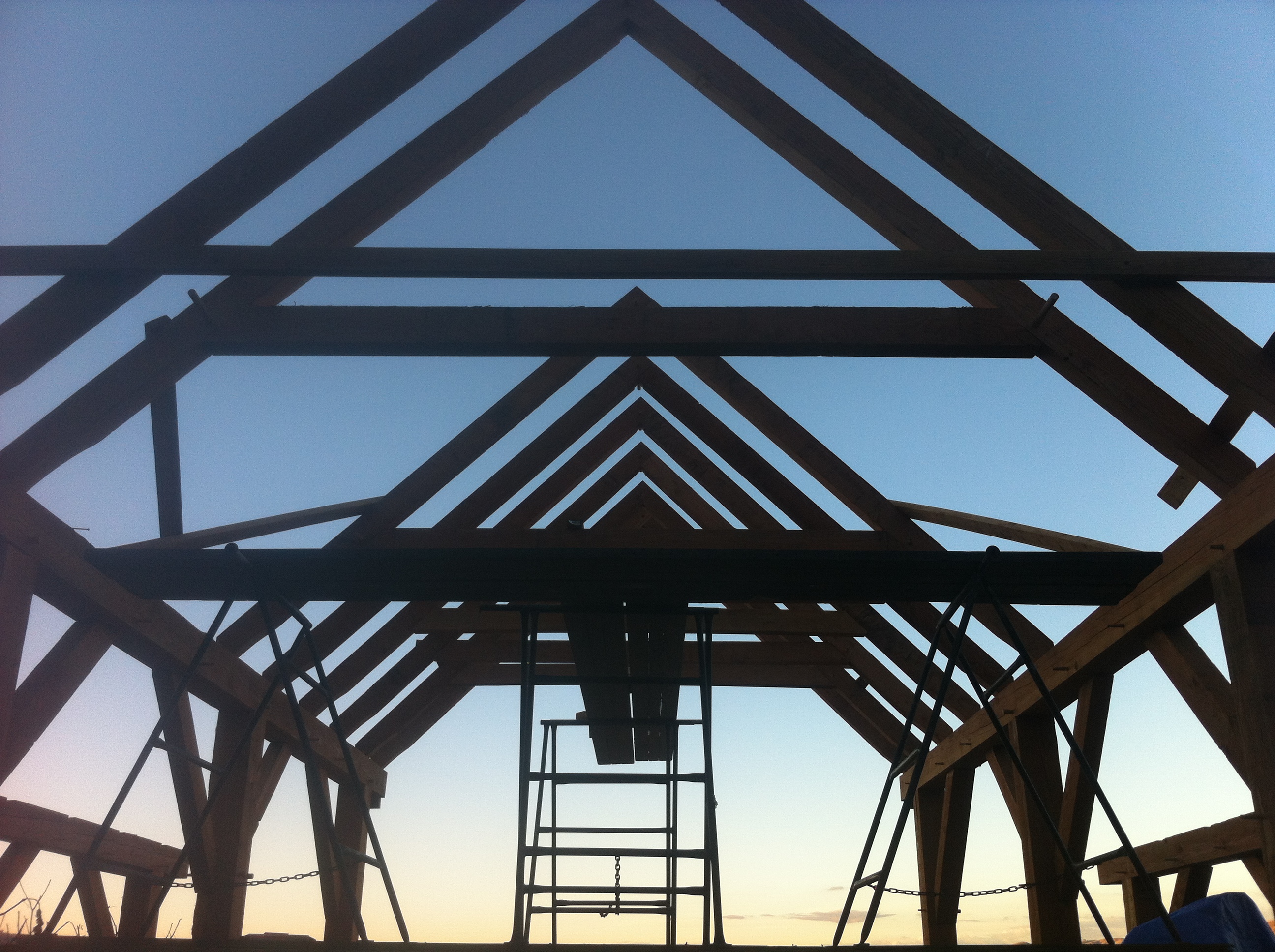

raftersInTheDark

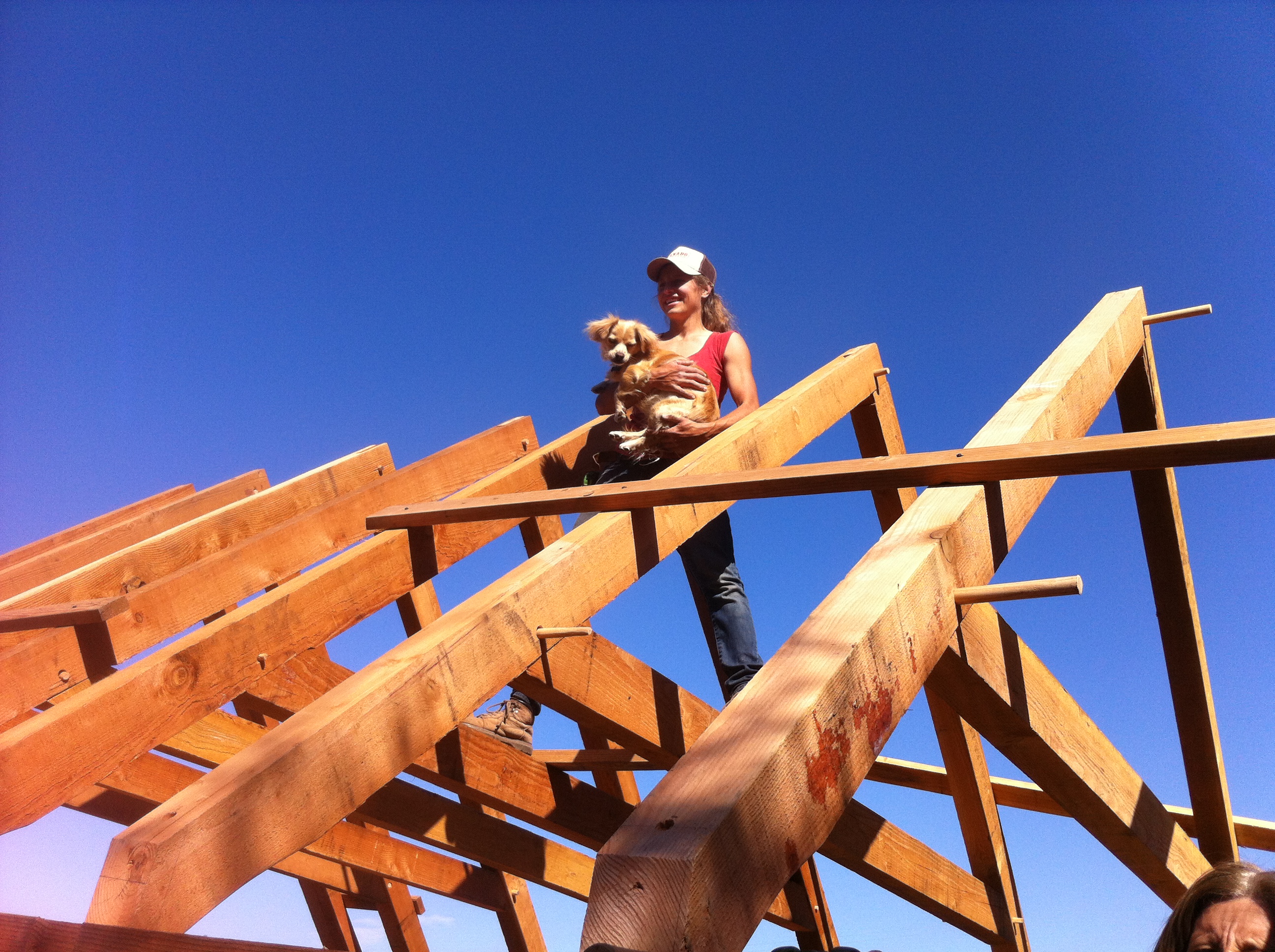

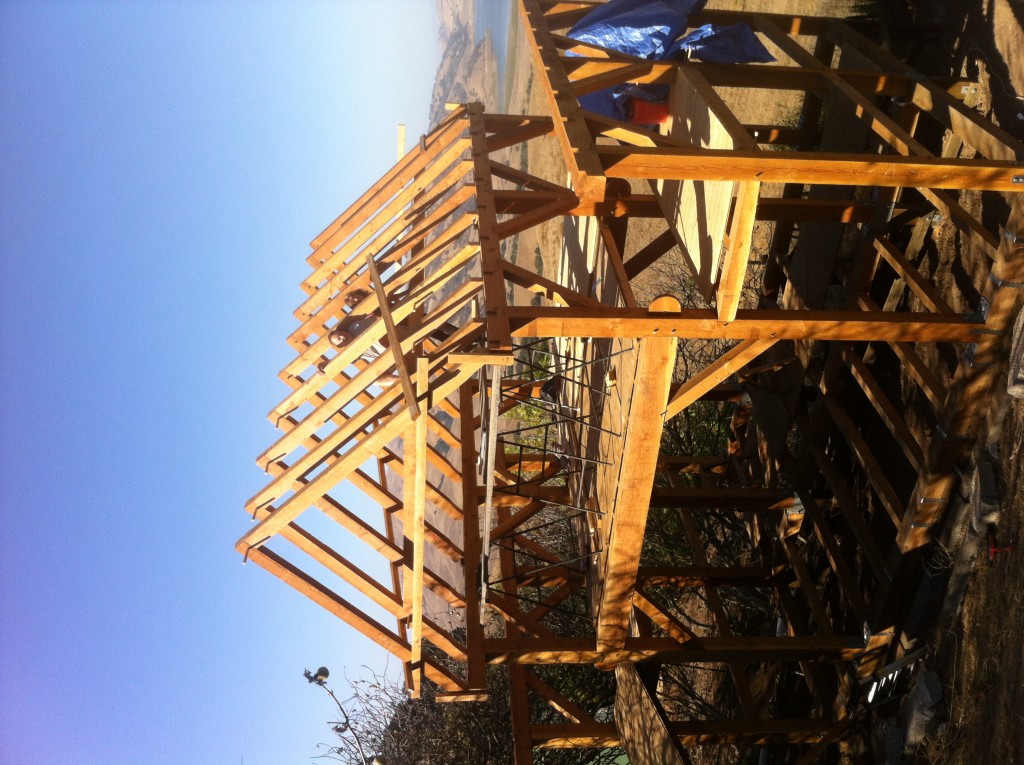

mamaAndPapaOnRafters LenaAndChapaOnRafters2

The complete frame:

fullFrame1

In early October, we built a stone block retaining wall on the uphill side with stairs leading down to the building:

steps3

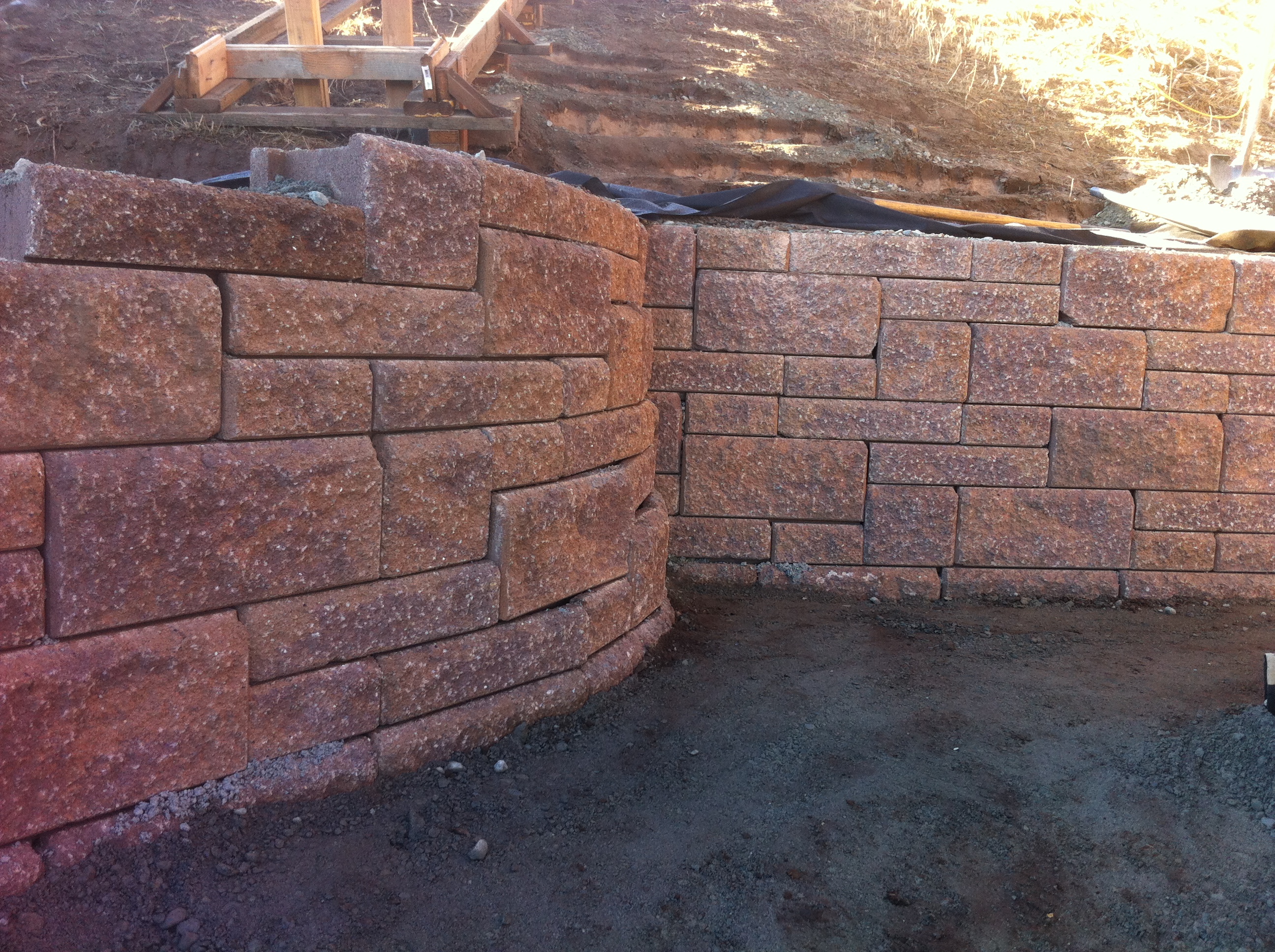

retainingWall1

retainingWall2

Lugging all of the block and wall rock down the hill with the railroad took a lot out of my carabiners. This is what our lives were hanging on (plus a backup biner!). Who knew rope could chew through metal faster than the metal could wear down the rope:

carabiner

We decked out the ceiling in mid-October with tongue and groove pine 2x8s.

startOfDecking

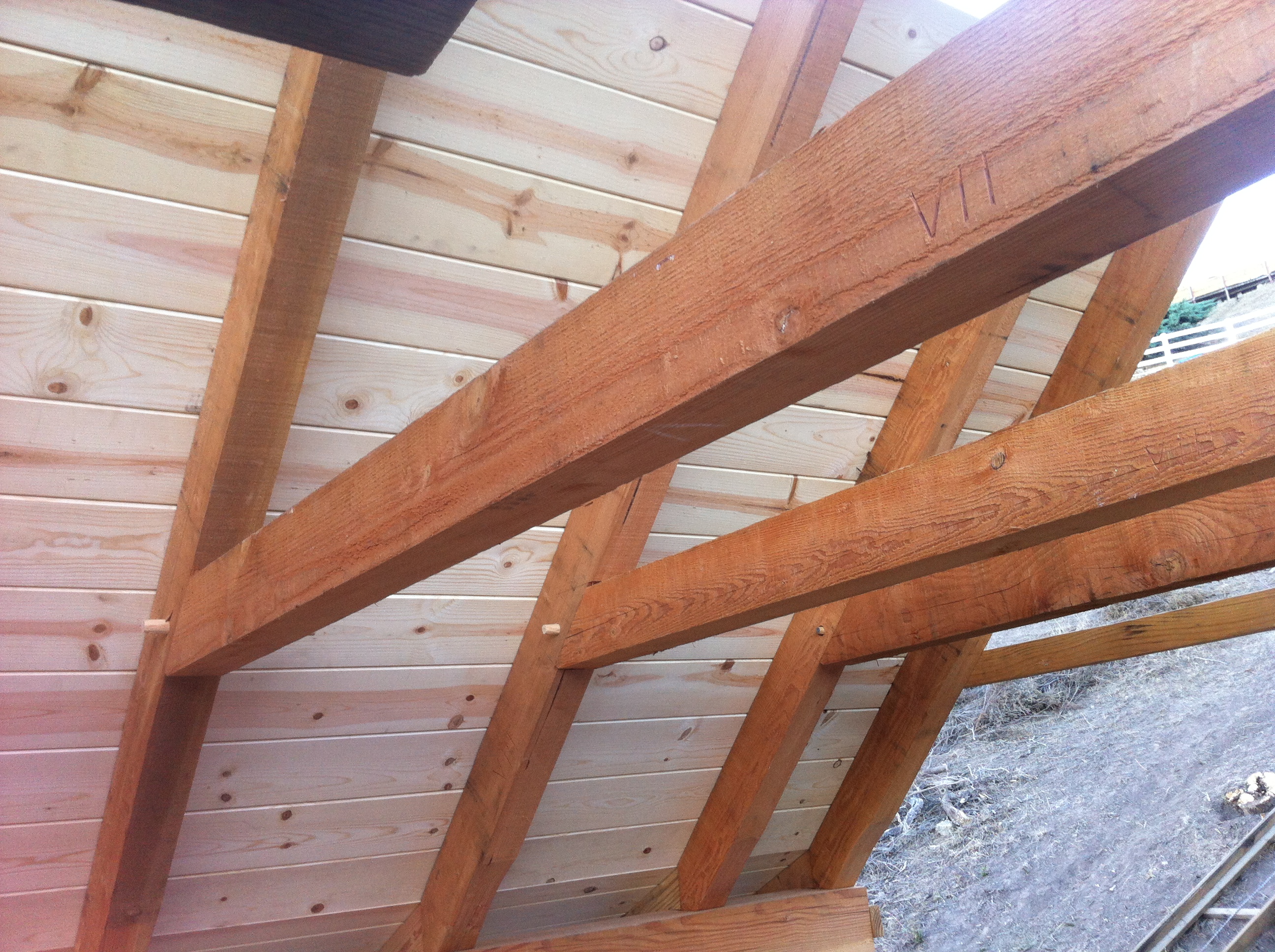

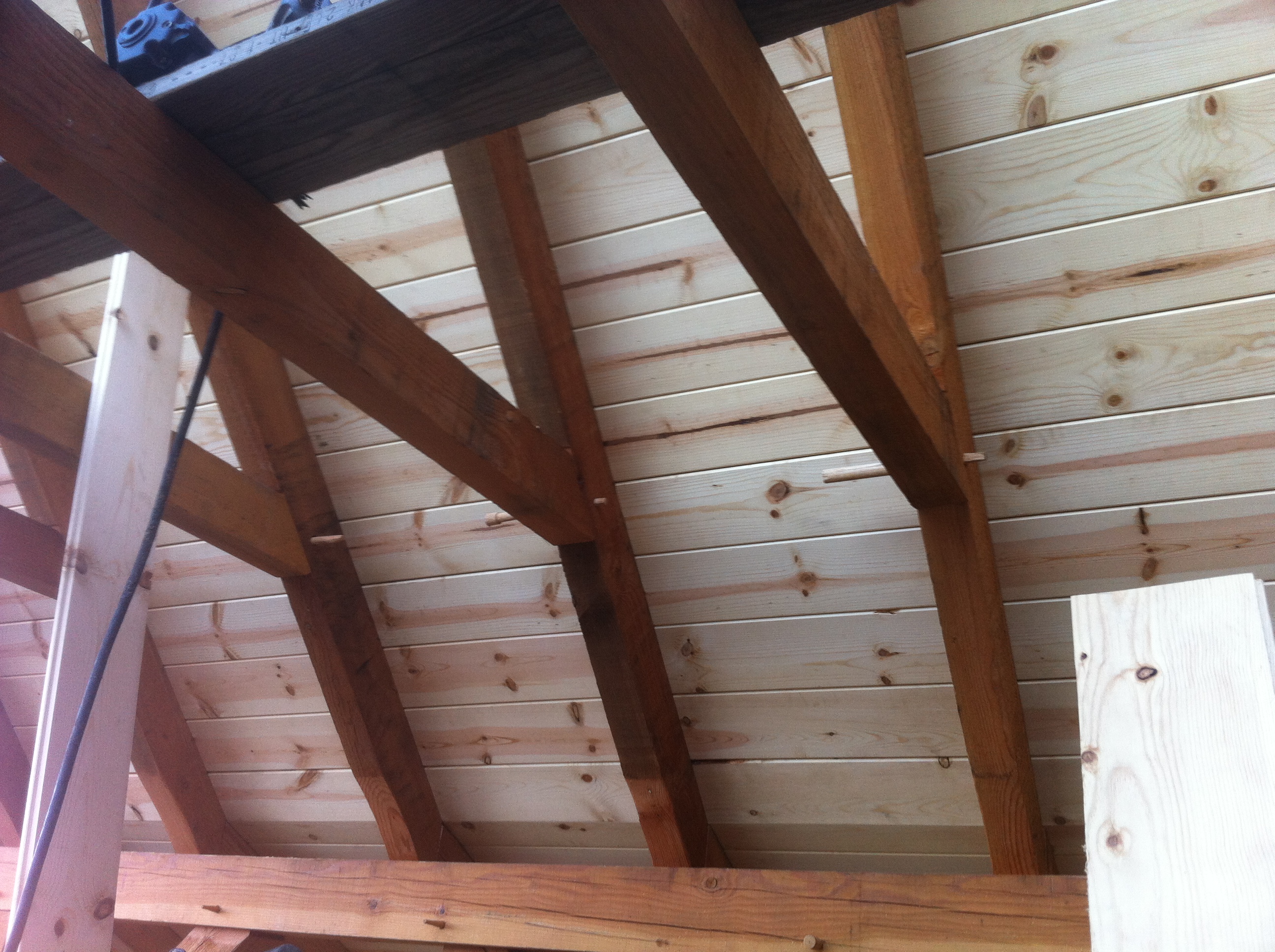

ceiling4 fromBelow ceiling5

In late October we put on the underlayment: Shark’s Skin. Similar to an ice and water shield, this stuff sticks even to things you wish it wouldn’t stick to. It can withstand weather for up to six months without the final roofing.

roofing

The metal roofing went on in November. It was tricky to lay the panels on the 12:12 pitched portion of the roof. Climbing harness, quick draws, and all those climbing knots came in handy!

roofing

I built a loft balcony in December and started running the electrical, sheathing, and wrapping the walls.

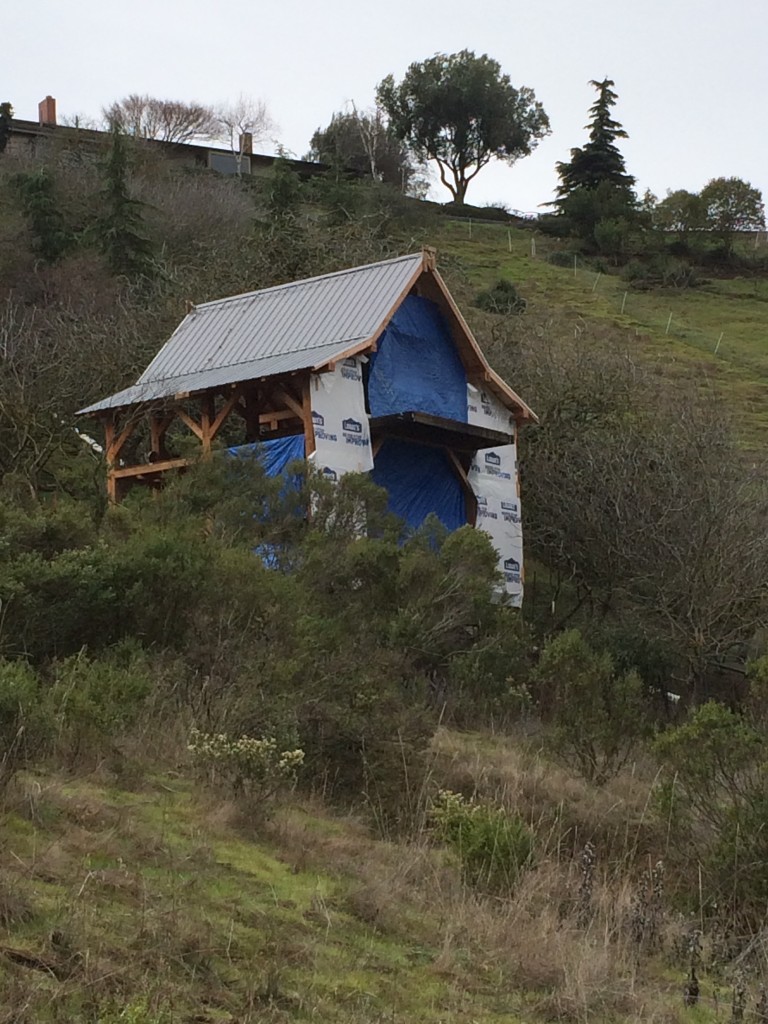

sheathing

El Niño finally arrived and prioritized making an additional drainage system to prevent further runoff of the soil surrounding the foundation. I decided to plant barley as a measure of erosion control on the hill.

runoff railroad barley

In late February, I finished sheathing and wrapping all four sides of the house. The electrical and lights were connected and tested in March. We mounted the windows in early April and by mid-April, I finished making the sliding barn doors.

balconyWindow door mid construction

houseFromBackside houseFromFront
